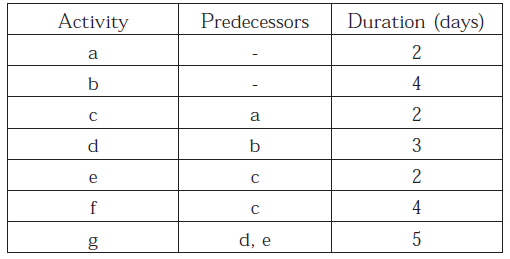

Q. 60 The precedence relations and duration (in days) of activities of a project network
are given in the table. The total flot (in days) of activities e and f , respectively,
are
(A) 0 and 4
(B) 1 and 4
(C) 2 and 3
(D) 3 and 1
Answer: (B )

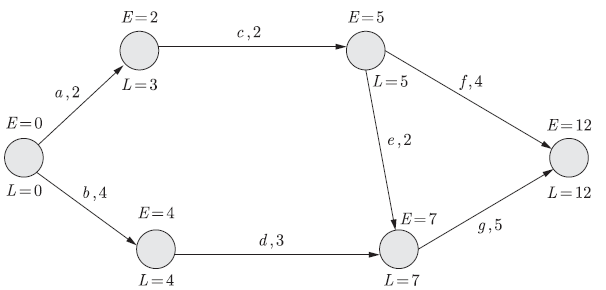

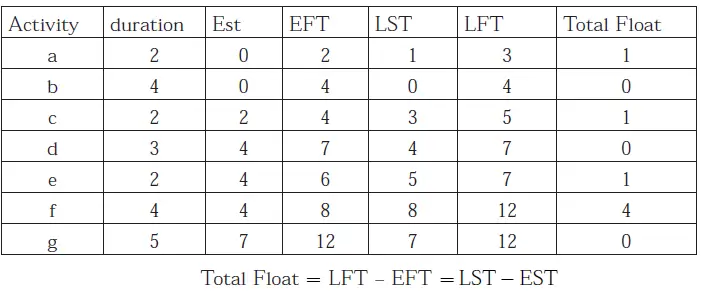

Explanation:
